The Kennesaw Deck That Looked Fine and Wasn't Attached Correctly
The homeowners called about replacing gray, splintered boards. The boards were the safest part of the structure — the ledger was nailed to the rim joist with no flashing.
- Scope
- Full deck demolition and rebuild, 480 sq. ft., cedar decking, pergola, lighting
- Timeline
- 18 days
- Investment
- $42,500


The deck was 16 years old, the surface was cupped and gray, and the family wanted to host again.
They expected a resurface: new boards on the existing frame, which is what two other companies had quoted.
We pulled a board at the house wall. The ledger was fastened with 16d nails and no structural screws or bolts — the single most common cause of deck collapse.
There was no flashing above the ledger. Water had been running behind it into the rim joist, which was soft enough to take a screwdriver by hand.
Two footings were shallower than frost depth and one post had no positive connection to its beam. Resurfacing would have put new boards on a frame that was already failing.
- Complete demolition and rebuild. We showed the homeowners the ledger and the soft rim joist in person before quoting anything.
- New footings to depth, through-bolted ledger with proper flashing, and hardware at every post-to-beam and beam-to-joist connection.
- Cedar surface over pressure-treated framing, plus the pergola and lighting they wanted — added at the framing stage so posts could be sized for it instead of bolted on later.
Days 1–3 — Demo, layout, footings
Old structure removed, footings dug to depth and inspected before concrete.
Days 4–9 — Framing
Rim joist section replaced, ledger through-bolted and flashed, beams and joists set with rated hardware, pergola posts integrated.
Days 10–14 — Decking and railing
Cedar deck boards with hidden fasteners, railing built to code height and infill spacing.
Days 15–18 — Pergola, lighting, finish
Pergola rafters, low-voltage lighting in posts and stair risers, sealer, final inspection.
- Every structural connection is now rated hardware, flashed and inspected — documented with photos for the homeowners' records.
- 480 square feet of deck plus a pergola and lighting for $42,500, delivered in 18 days against a 3-week estimate.
- The two resurface bids were roughly $12,000. They would have left a nailed ledger holding a family gathering.
Before you pay to resurface a deck, have someone pull one board at the house wall. The ledger connection and its flashing tell you whether you have a repair or a rebuild.
Want this kind of diagnosis on your own project? We'll walk it with you and tell you honestly whether it's a repair or a rebuild.
Call 404 · 922 · 9209Drag each photo to see exactly what changed.
Every project is photographed at the decision points that matter — the connection, the pan, the base, the grade — not just the finished room.

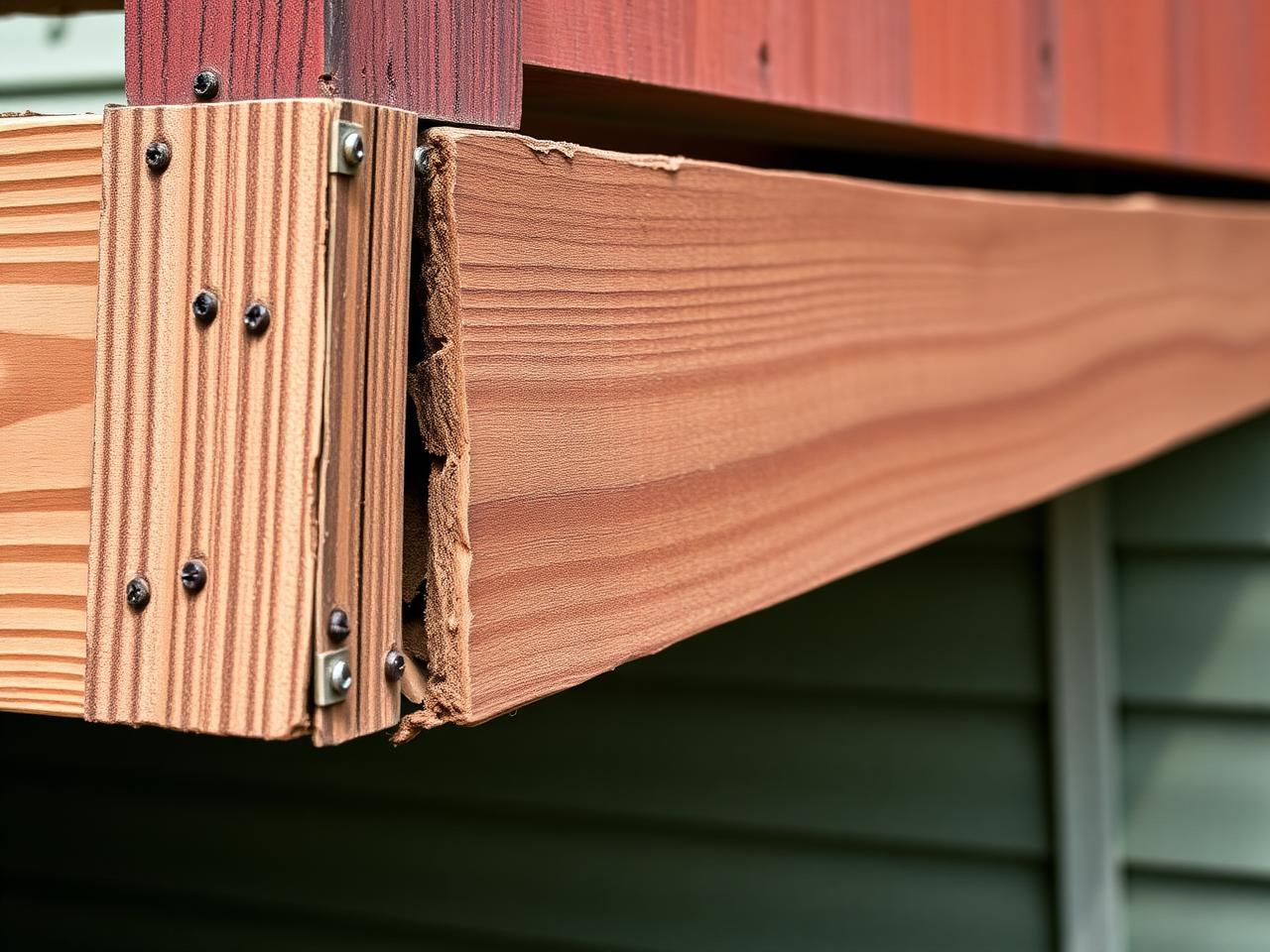

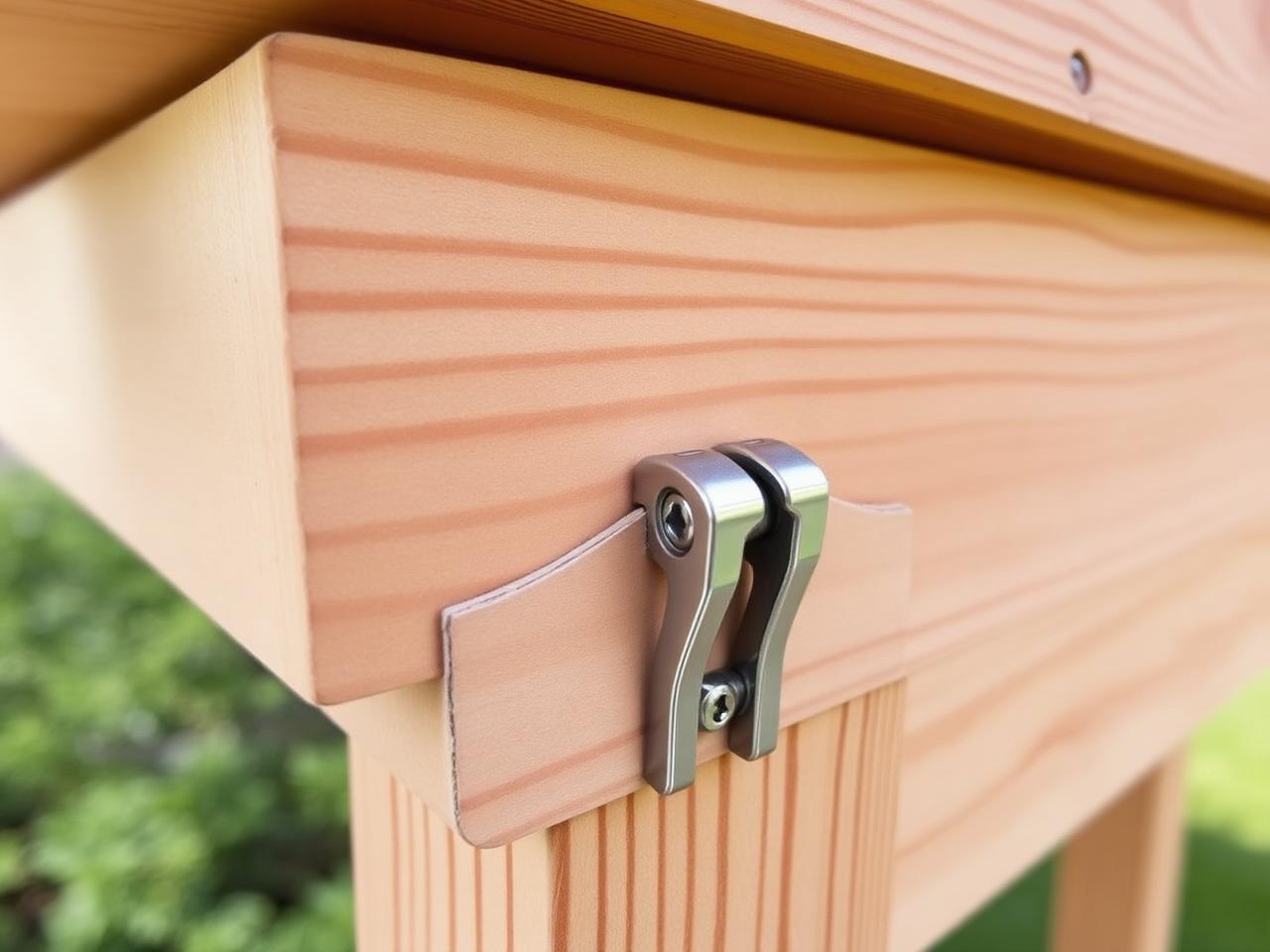

BeforeAfterThe connection that was actually failing
Nailed ledger, no flashing, rotted rim joist — the exact detail that causes deck collapses. Rebuilt with structural fasteners and flashing tape.

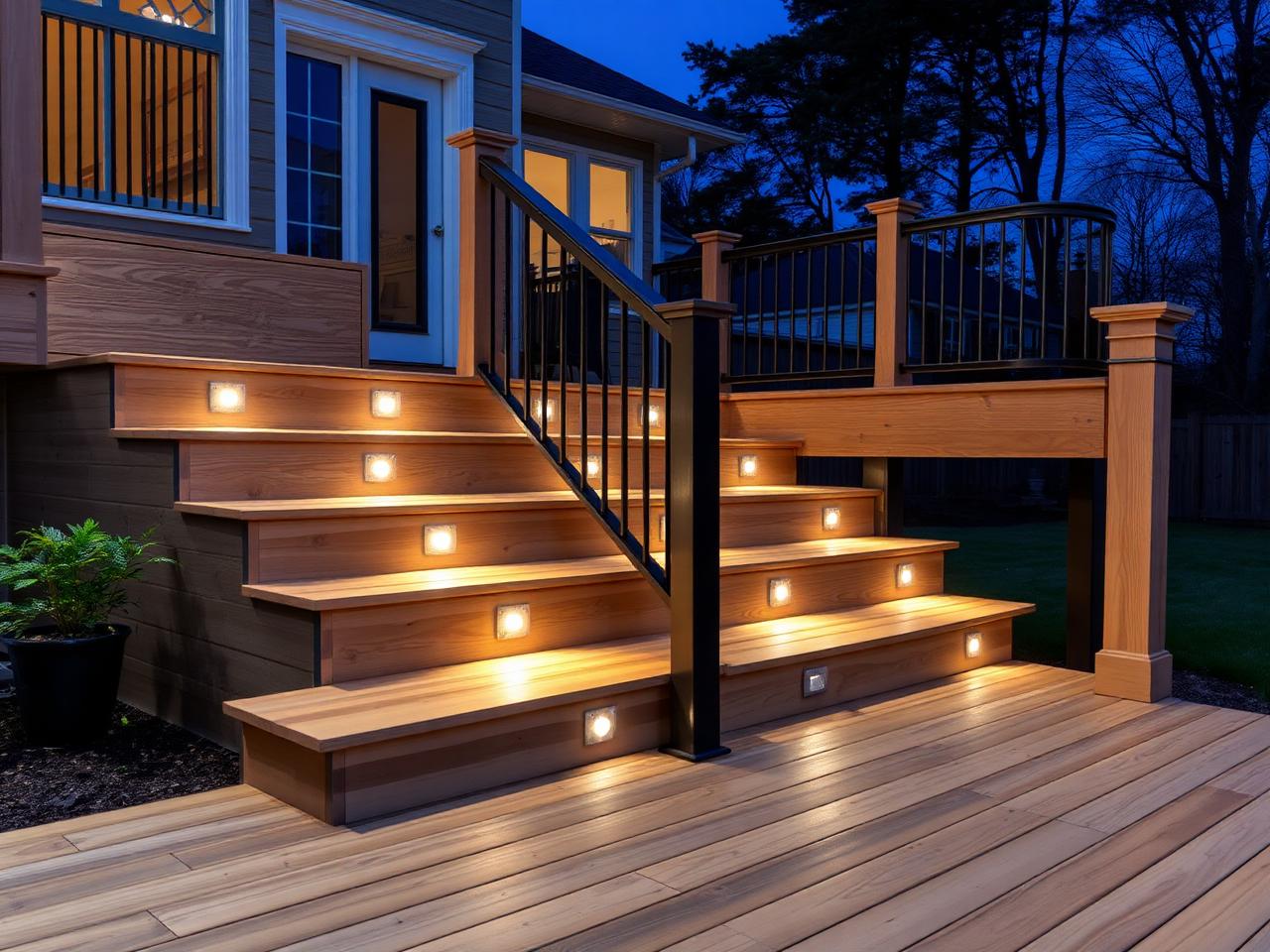

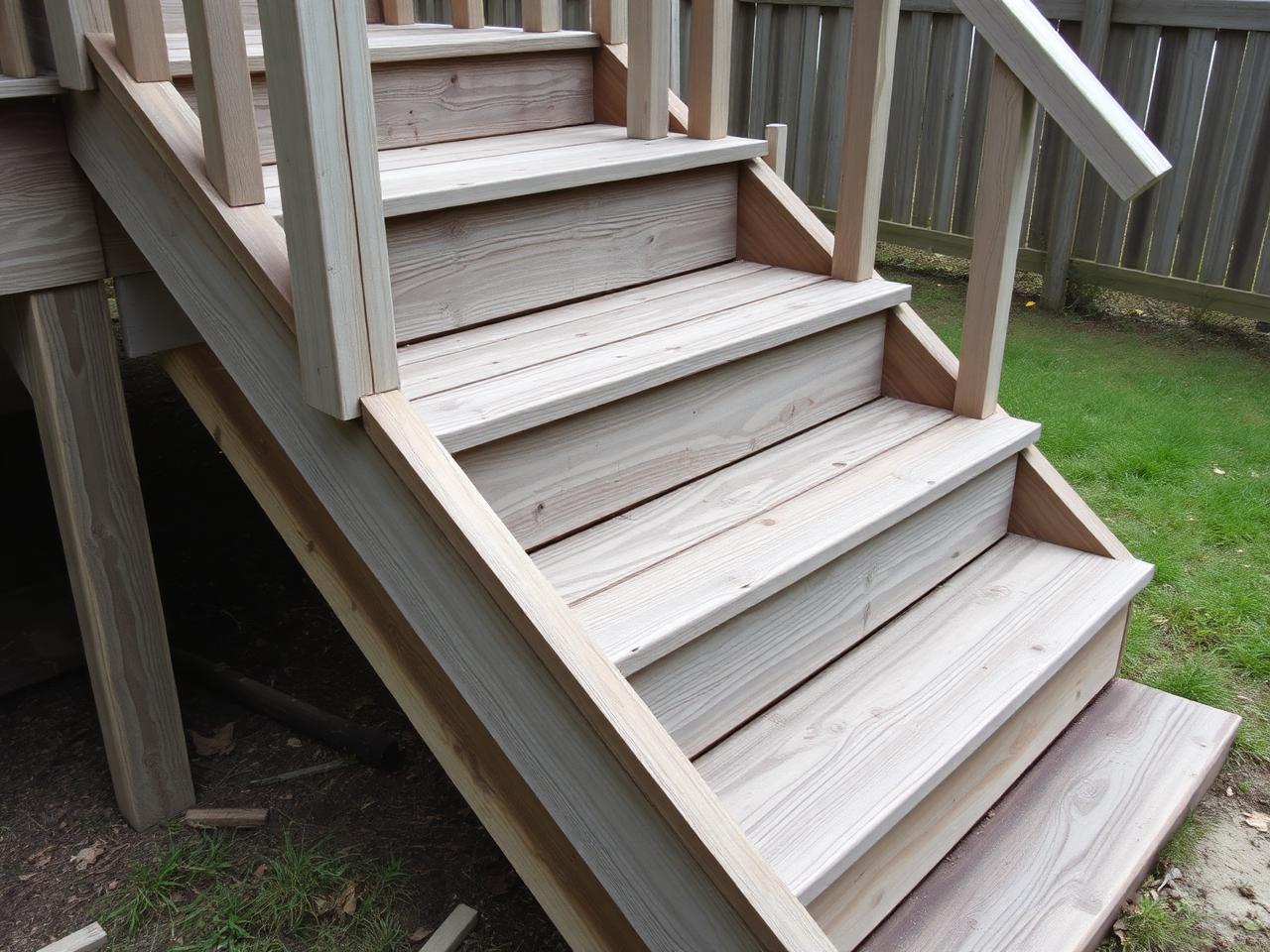

BeforeAfterStairs rebuilt to code, then lit
Old treads were undersized with a loose railing. New stairs carry consistent rise-and-run, a graspable rail and integrated riser lighting.

Ready to build something
exceptional?
Get your complimentary 3D design and personalized estimate. We accept a limited number of projects each season — reserve your consultation today.
